Construction report, 29 Aug 2025

Construction report Time Square 8 2025-08-29 · date from document content Original: EN 16 pp.

A newer version exists: Construction report, 29 Nov 2025

Summary

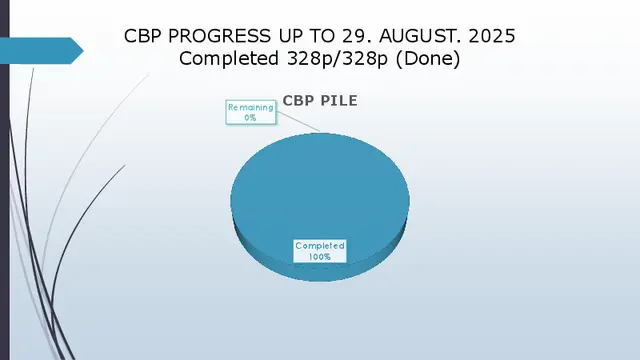

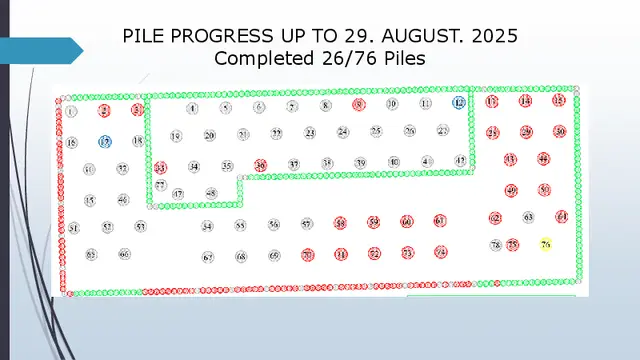

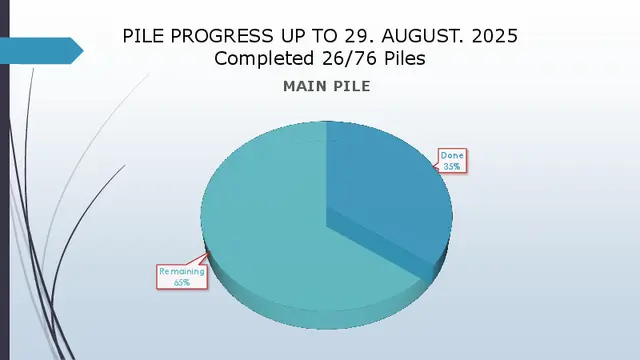

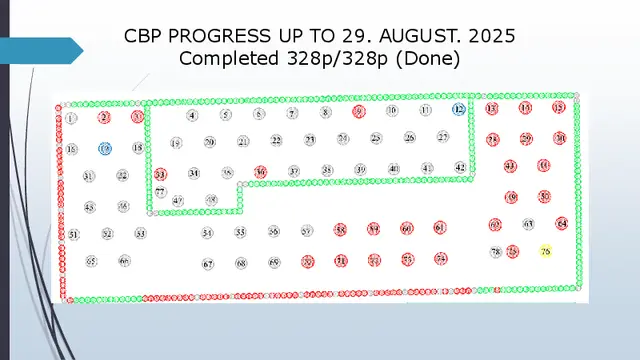

All 328 contiguous bored piles done; main piles 26 of 76; piling due to finish 25 Oct 2025.

Key facts

CBP piles 328/328Main piles 26/76
